Basement Finishing Permit in Ontario: Requirements and Process
Just wondering if your specific project needs a permit?
If you are unsure whether your project (like underpinning, adding a bathroom, or just insulating) triggers a permit requirement, skip to our project checklist guide: Do I Need a Permit to Finish My Basement? (Project Checklist).
Finishing a basement is one of the most common projects we draft for homeowners across the GTA, and it’s also one of the most rigorously inspected. The phrase “I’m just putting up some drywall” hides a long list of strict Ontario Building Code (OBC) requirements that municipal examiners scrutinize before issuing a permit.
Here is the definitive 2026 technical guide to the exact measurements, fire safety regulations, and documentation required for a successful basement finishing permit application.

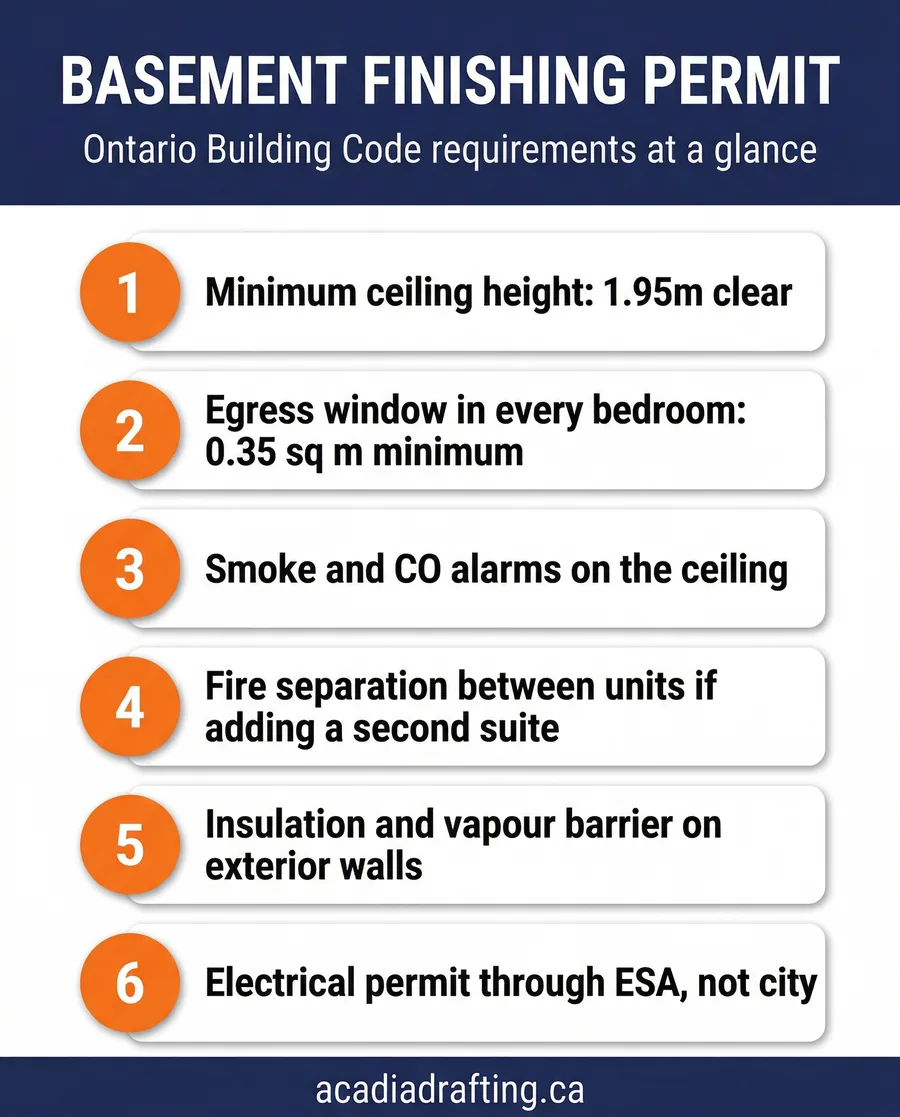

What the Ontario Building Code Requires for Finished Basements
Egress and Bedroom Windows
Every bedroom in a finished basement needs an egress window or door. The OBC sets the minimum unobstructed openable area at 0.35 square metres with no dimension less than 380 mm, and the sill must be no more than 1.5 metres above the floor. Window wells must allow the window to fully open and provide enough room for an adult to climb out. Undersized window openings are the single biggest cause of rejected basement permit drawings.
Ceiling Height Clearances
The OBC allows a minimum finished ceiling height of 1.95 metres (6 feet 5 inches) in basements over the required floor area. Beams, ducts, and bulkheads can drop to 1.85 metres in localized spots. If your existing basement is shorter, you must undergo underpinning to lower the floor before adding living spaces.
Smoke and CO Alarms
Interconnected smoke alarms must be installed on every level and inside every bedroom. Carbon Monoxide (CO) alarms must be installed within 5 metres of every sleeping room. These are non-negotiable life-safety systems.
Ventilation, Heating, and Plumbing
New bathrooms and kitchens require mechanical ventilation exhausted to the exterior. If you are adding new living spaces, your HVAC contractor must provide a heat loss/gain calculation that matches your architectural drawings to ensure the existing furnace can handle the load. Additionally, basement bathrooms require a backwater valve to prevent municipal sewer backups.
Second Unit (Legal Basement Apartment) Requirements
If you’re going beyond a single-family finished basement and creating a registered second unit (rental suite), the OBC requirements jump significantly:
- Fire Separation: A continuous 30-minute or 45-minute fire separation (typically Type X drywall) between units and around utility rooms.
- Sound Transmission: An STC 50 sound transmission rating between the upper and lower units.
- Independent Utilities: Separate heating controls (zoned thermostats) or completely independent HVAC systems.
- Separate Entrance: An independent egress that doesn’t pass through the upper primary unit.
The Drawing Package Examiners Expect
You cannot submit rough sketches to the city. A professional drawing package must include:
- Site plan showing the property lines and the basement footprint.
- Existing and proposed basement floor plans (to scale).
- Reflected ceiling plan detailing bulkheads and dropped soffits.
- Cross-section drawings showing ceiling heights, floor assemblies, and window heights.
- Window schedules with precise egress calculations.
- Wall and floor assembly details noting specific fire ratings.
Common Rejection Reasons in 2026
- Egress window area calculations are missing or mathematically undersized.
- Ceiling height is drawn but not explicitly labelled.
- Fire separation continuous lines are omitted or under-rated on the cross-sections.
- Mechanical ventilation and HVAC heat-loss calculations are missing.
- No backwater valve is shown on the plumbing schematic.
The good news is every one of these is preventable at the drafting stage. If your project is already stalled, we provide rejected permit help to get it back through review.
Save this as a PDF and keep it on hand for your project planning.
